workstyle · Oct 9, 2025

Project Management KPIs: How to Define, Set Up, and Track Them

key performance indicators

Last updated: October 29, 2026

TL;DR

A KPI is a measurable value that shows whether you're moving toward a specific objective. Every KPI is a metric, but not every metric is a KPI; the test is whether tracking it would actually change a decision. Most teams track too many. Aim for three to five per team or project, covering outcome, quality, and timing. In Quire, KPIs work best as a custom-field formula that scores each task on completion and timing so the indicator updates with the work itself instead of in a separate dashboard.

Most project KPI dashboards die quietly after the first quarter. Someone builds a 30-row spreadsheet in week one, the team admires it, and by month three nobody opens it.

Blame lands on the spreadsheet, but the damage is definitional. "KPI" got stretched to mean "any number we can measure," and a list that long can't tell anyone what to do on Monday.

The project management KPIs that survive are narrower. They're the handful of metrics that, if they moved, would change what your team does next sprint.

For a project manager, that line is the whole job. You don't need your team's average task touch-count. You need to know whether work is shipping on time, whether the budget is holding, and where things keep getting stuck.

This post is about the project management KPIs worth tracking, how they're different from the vanity metrics that just pad a dashboard, how many to run (fewer than you'd think), and how to set them up in Quire so the number updates as the work moves instead of when someone remembers to refresh a slide.

The need only sharpens as you scale: KPIs are how growing teams keep shared visibility once no one can eyeball every task by hand.

What Are KPIs?

Definition

Key performance indicator (KPI): a measurable value that shows how effectively a person, team, or organization is hitting a stated objective. What separates a KPI from a metric is the objective. A number nobody has tied to a decision is a metric. A KPI is the number that changes what the team does next.

A KPI turns a goal into a number you can check, so progress stops being a feeling and starts being a fact.

For example:

  • In project management, a KPI could be the percentage of tasks completed on time.
  • In sales, a KPI could be the number of new clients closed each quarter.
  • In marketing, a KPI could be the conversion rate from campaigns.

Put simply, a KPI tells you “where you are” versus “where you want to be.”

A number on its own never says what you were aiming at: the OKR template your team won't quietly abandon by Q2, for pairing each KPI with the goal it exists to serve.

Which Project Management KPIs Should You Actually Track?

The project management KPIs worth tracking are the ones that light up where projects predictably fail: the schedule slips, the budget creeps, throughput stalls, quality drops, or the team burns out. On-time completion rate, cost performance index, cycle time, rework rate, and overdue task count are the headline example for each front. Pick by how your projects fail.

KPI category Example KPIs What it tells you
Schedule On-time completion rate, schedule variance Whether you'll hit the date while there's still time to react
Budget Cost Performance Index (CPI), budget variance Whether you're earning the value you're spending
Throughput Cycle time, tasks completed per sprint How fast work actually moves from started to done
Quality Rework rate, first-pass review rate Whether "done" is staying done
Team & resources Workload balance, utilization, overdue task count Whether the plan is survivable for the people running it

You won't track all of these, and you shouldn't try. Pick the two or three that map to how your projects actually fail, and let the rest go. (Yes, let them go. A dashboard with five honest numbers beats one with forty decorative ones.)

Give those two or three a home in ten minutes: build a KPI dashboard in Quire from the tasks you already track, so the number updates itself.

Once you've picked the two or three, they need somewhere to live: a project dashboard template that tracks what actually matters, laid out so the figures assemble themselves instead of getting retyped every week.

Which Project Management KPIs Measure Planning and Scheduling?

The best scheduling KPIs are on-time completion rate, schedule variance, schedule performance index (SPI), milestone slip rate, estimate accuracy, and schedule coverage. Each one measures whether the plan holds once real work starts. They catch different failures, so pick the one that matches how your dates usually go wrong.

A date rarely slips in one dramatic jump. It slips a day at a time, in places nobody's measuring.

Scheduling KPI How to calculate it What it warns you about
On-time completion rate Tasks finished by their due date ÷ all finished tasks Whether dates are being met at all
Schedule variance (SV) Earned value − planned value How far ahead or behind plan you are, in budget terms
Schedule performance index (SPI) Earned value ÷ planned value Work is landing slower than planned whenever it drops below 1.0
Milestone slip rate Milestones moved past their original date ÷ milestones due Whether the big dates are drifting a week at a time
Estimate accuracy Actual duration ÷ planned duration Whether the plan was realistic in the first place
Schedule coverage Open tasks with a due date ÷ all open tasks How much of the work the schedule can even see
  • Start with on-time completion rate. It's the cheapest one to run, because it only needs a due date and a completion date on each task. The KPI Point formula further down scores exactly this, one task at a time.
  • Add SV and SPI only if you already track earned value. Both come from earned value management, so every chunk of work needs a budget attached before the math means anything. Without that, on-time rate points the same direction for a fraction of the setup.
  • Watch milestone slip rate on long projects. One late task is noise. A project milestone that's moved three times is a pattern, and it tells you the work underneath was sized on hope.
  • Check schedule coverage before you trust the rest. A task with no due date can't be late, so it never drags a number down. If half your open work is undated, your on-time rate is grading the easy half.

In Quire, the schedule data already sits on the tasks. Due dates and completion dates feed the scoring formula below. Milestones carry their own dates and roll up progress from the tasks linked to them, and the Deadline Calendar widget shows what's coming due while there's still time to move it.

What Is a Performance KPI in Workload Management?

In workload management, performance KPIs measure how well tasks get finished, not just whether they get finished. Raw volume (how many tasks are done) misses the point. What you actually care about is quality, efficiency, and timeliness.

Some examples of performance KPIs in workload management include:

  • Task Completion Rate: The percentage of assigned tasks finished within a given timeframe.
  • On-Time Delivery Rate: The ratio of tasks completed before or on the deadline.
  • Overdue Tasks: The number of tasks not completed by their due dates.
  • Workload Balance: The distribution of tasks among team members.

Why does this matter? Because in real projects, it’s not enough to just get things done, you need to get them done on time and to the right standard. That’s exactly what tracking KPIs in workload management tells you.

Why Are Key Performance Indicators Important?

If most KPI dashboards die quietly, why keep building them? Because when the numbers are the right ones, five things change:

the importance of key performance indicators

1. How Do KPIs Provide Clarity and Focus?

Every project generates noise: pings, side requests, and tasks that feel urgent mostly because someone typed them in all caps. A well-chosen KPI works as a filter. It tells the team not just what to do but why it matters this sprint.

It also keeps marketing, operations, product, and leadership arguing about the same number instead of four different ones. Working hard on the wrong things is the most expensive habit a team can have, and it never shows up on a timesheet.

2. How Do KPIs Drive Accountability?

Without KPIs, accountability turns into opinion, and opinion turns into office politics faster than anyone would like. A number takes the personal sting out of the conversation. You’re not saying “you’re slow,” you’re asking “cycle time doubled this month, what changed?”

That’s a fairer deal for everyone. People get measured against the same visible yardstick, not against who presents best in the Monday meeting.

3. How Do KPIs Power Continuous Improvement?

A single KPI reading is a snapshot. The trend is the story. Track one for a few sprints and the patterns surface: the review stage that always jams, the teammate quietly carrying a double load, the delay that shows up every quarter like clockwork.

That’s the shift from asking “Why are we behind schedule again?” to saying “Let’s rebalance tasks earlier next sprint.” Same data, but now you get to use it before the fire instead of after.

4. How Do KPIs Build Motivation?

Invisible progress is demoralizing. You can grind for three weeks and have nothing to show for it except a slightly shorter task list, which nobody frames and hangs on the wall.

A climbing chart fixes that. Watch your on-time completion rate go from 60% to 85% and the whole team feels it. The number becomes something worth defending. KPIs are as much about celebrating wins as they are about spotting gaps.

5. How Do KPIs Sharpen Decision-Making?

Gut feeling is a fine tiebreaker and a terrible primary source. KPIs give you receipts. If tasks keep slipping because two people are doing the work of four, the overdue count makes the case for hiring better than any impassioned Slack message ever will.

And it cuts both ways. If the team keeps beating its targets, the same numbers give a manager cover to aim higher.

Without KPIs, you’re driving with the dashboard covered. The engine might be fine. You just won’t know until something starts smoking.

New in Quire: Dashboard View. See everything your team is shipping at a glance

How Do You Set Up KPI Tracking in Quire?

Enough theory. In Quire, a collaborative project management platform, a KPI can live inside the project itself and update as the work moves; no spreadsheet, no relying on someone’s Friday-afternoon diligence to refresh it.

Here’s how to set up performance KPI tracking in Quire, step by step:

Step 1: Create a Custom Field for KPI Calculation

For tracking task performance, create a column in the custom field, name it KPI Point, apply the following formula, and choose the format as Number.

COUNT(assignees) * ((due = null) ?? false ? null: status < 100 ? (due < <today>) ? -2: 0: (completedAt < due) ? 1: -1)

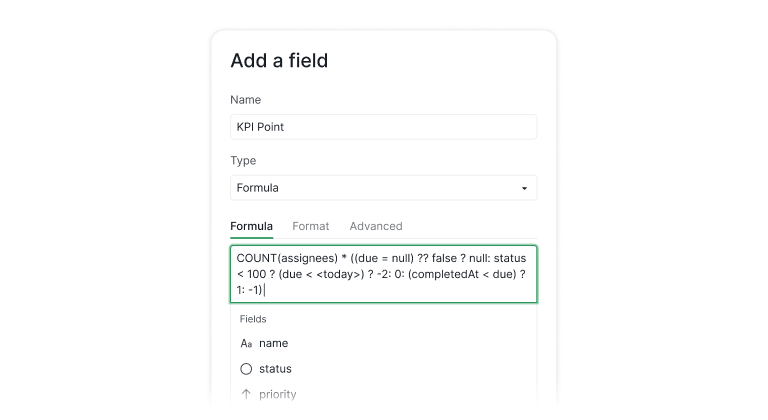

Quire custom field creation dialog for KPI Point with performance scoring formula

Here’s what this formula does:

  • 1 point → if the task is completed before the due date.
  • - 1 point → if the task is completed after the due date.
  • - 2 points → if the task is overdue and not completed.
  • 0 points → if the task is not executed yet but still within the due time.

A score people can edit is a score people will argue about. Lock the fields the KPI formula reads, so the points come from the work and not from a retyped cell. See how to lock a Custom Field.

This system creates a performance scoring model for every task assigned.

Step 2: Apply KPI Tracking Across Tasks

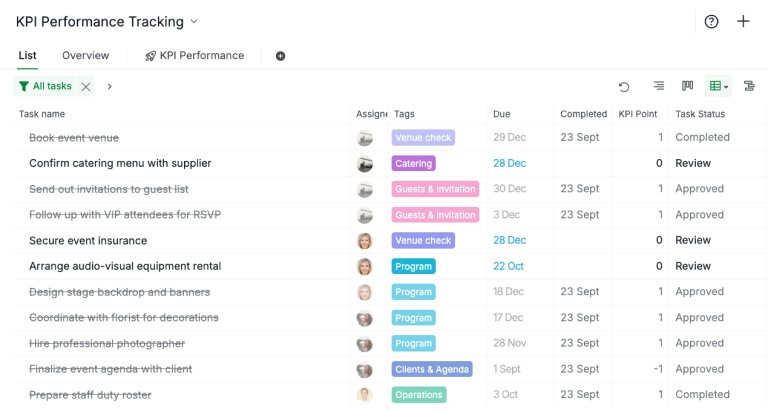

key performance indicator table

Once the field is created, every task in your project with a due date picks up a KPI Point on its own. Each task now carries a performance score based on completion status and timing, no manual scoring needed.

This gives you a quick way to assess:

  • Which team members consistently complete tasks on time.
  • Which projects are running into delays.
  • Where overdue tasks are piling up.

Step 3: Visualize KPI Data With Charts

Numbers are useful, but visuals make KPIs actionable. In Quire, you can generate charts to visualize KPI trends over time.

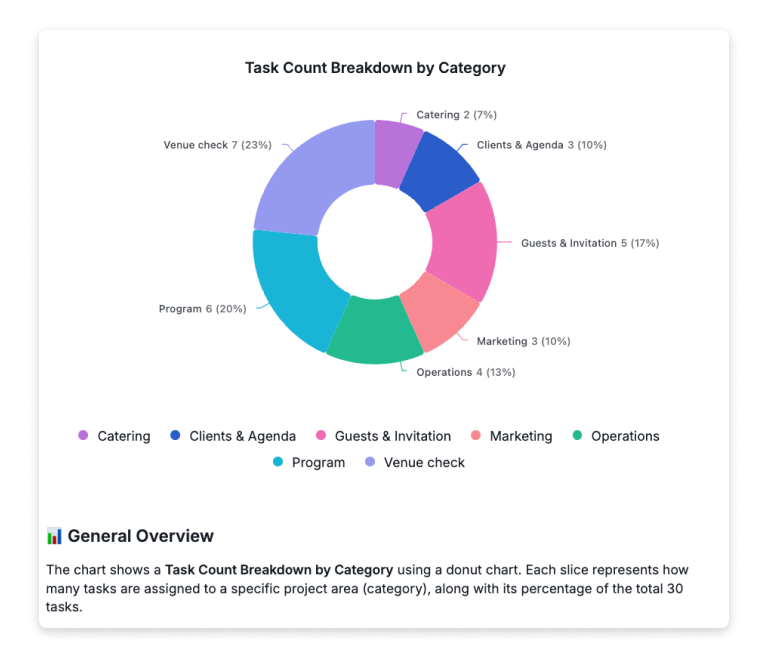

key performance indicator data

For example:

  • Pie Chart → Visualize the task count breakdown by task categories.

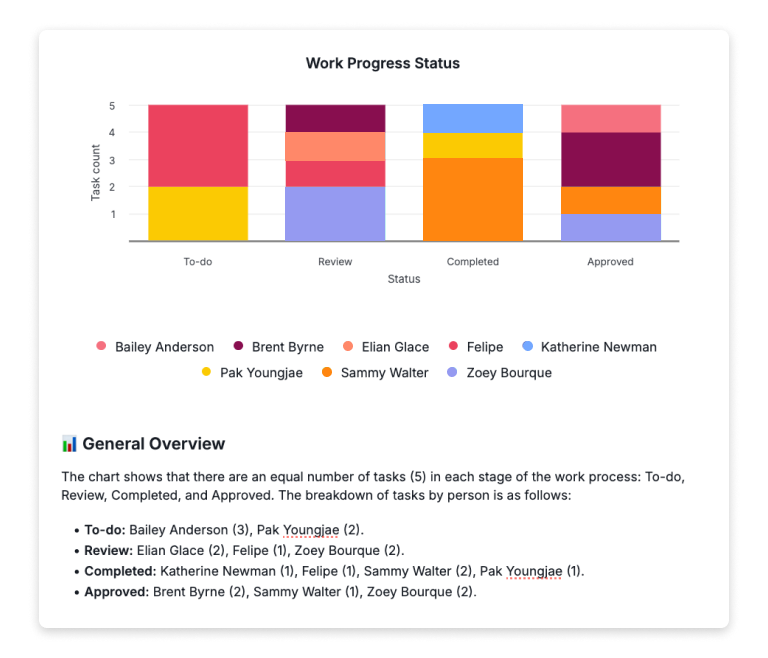

  • Stacked Bar Chart → Visualize the work progress status

KPI data visualized as pie chart showing task distribution by status or category

Stacked bar chart visualizing KPI work progress status by completion stage

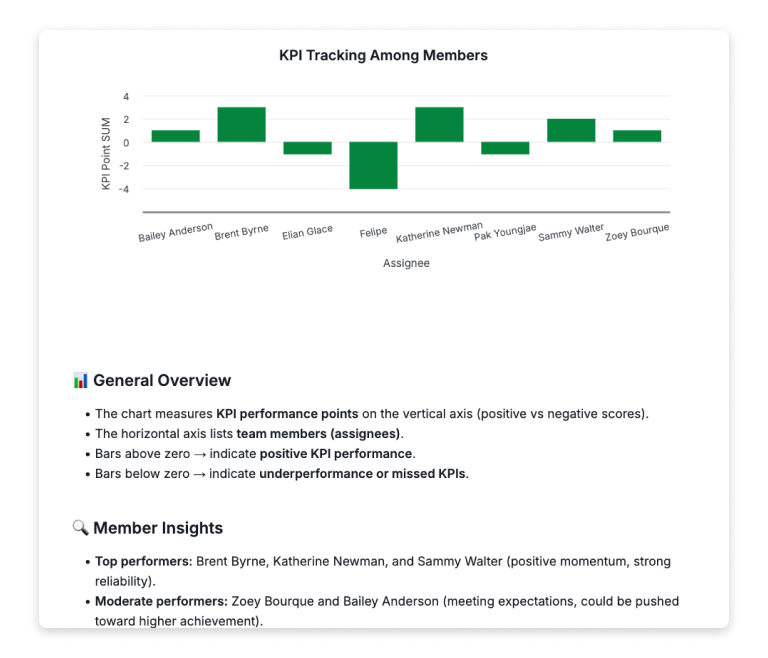

This makes it easy for managers to identify patterns. For instance, if a team’s KPI scores are consistently low in the last two weeks, it may signal workload imbalance or resource issues.

Step 4: Review and Adjust

KPI tracking isn’t “set and forget.” Use Quire’s reporting and charting features to review progress regularly.

A Dashboard makes that review routine: widgets like Task Status Distribution and Member Workload sit on one screen you already open every morning, so checking the numbers stops being a separate errand.

If the formula or scoring doesn’t reflect reality, adjust it.

For example, you could assign different weights to tasks based on priority or complexity.

KPIs read better when they're attached to something dated. Quire's strategic roadmap guide shows where the numbers hang: objectives at the top, initiatives underneath them, and quarterly milestones that give every metric a built-in review date instead of a vague "we'll check in Q3." To build one, start with how to build a strategic roadmap.

Setting next year's targets? The annual planning process that survives January walks a year's themes down to the tasks that move them, so every KPI ends up with a review date and a name on it.

What Comes With the Quire KPI Performance Tracking Template?

The KPI Performance Tracking template is the setup above, already built. It's a delivery-performance scorecard that scores every task on whether it beat its due date, then totals the score per person.

The sample data is a team running an event, so you can watch the scoring work before any of your own tasks go in.

Here's what's inside the project.

  • A KPI Point field on every task, calculated for you with the same rules as Step 1.
  • A KPI Performance document with three live charts. One shows KPI Point per person, one counts tasks by tag, and one splits task status by person. Each chart comes with notes on how to read it.
  • Five statuses, from To-do to Approved. In progress, Review and Completed sit in between. The scorecard treats Completed and Approved as finished, so a task in either one gets scored against its due date.
  • A How to use this template doc that covers the setup and the scoring rules in one page.

Making it yours takes five steps.

  1. Duplicate the project into your own organization from the dropdown next to the project name.
  2. Replace the sample tasks with your own, and give every one a due date and at least one assignee.
  3. Keep to one assignee per task where you can. The score multiplies by the number of assignees, so a shared task swings both totals twice as far.
  4. Let a full period run before you read the charts, since the scorecard grades finished work, not the plan.
  5. Delete the sample tasks once you have a period of your own to look at.

One thing to watch as your work moves in. A task with no due date gets no score at all, which is the schedule coverage problem from earlier in miniature. Date it, or accept that it doesn't count.

Open the KPI Performance Tracking template, duplicate it, and swap in this week's tasks. The charts start filling in as the work closes.

What's the Bottom Line on Tracking KPIs?

A KPI is only worth tracking if it would change what your team does next. Pick the three to five numbers that map to how your projects actually fail, and ignore the rest with a clear conscience.

Then make tracking cheap. One custom field, one formula, a chart or two, and the score updates itself while your team works. No quarterly spreadsheet resurrection required.

Ready to try it? Define the KPIs that matter to your team, set up the formula above in Quire, and let the numbers do the arguing for you.
