project management · Jun 2, 2026

How to Evaluate a PM Tool Without a 6-Month Trial

how to evaluate a pm tool

Last updated: June 2, 2026

TL;DR: Long PM tool trials produce worse decisions, not better ones. Run a two-week sprint instead: one real project, three shortlisted tools, a small team, a written must-have list, and a 10-question rubric scored on day 14. The tool people keep reaching for voluntarily by day 14 is the one that fits.

The standard advice for buying project management software goes like this. Trial five tools, assemble a cross-functional committee, score everything against a 47-item rubric, and make a careful decision over the course of a quarter. It sounds rigorous. It's actually a recipe for buying the wrong thing slowly.

Long trials produce worse decisions, not better ones. The team gets locked into sunk-cost thinking. The comparison gets stretched across projects with different shapes, so nothing is actually comparable. By the time the committee reaches consensus, the original problem has shifted, and whatever tool won the evaluation is now optimized for a problem you don't have anymore.

There's a faster, better way to do this. Two weeks. One real project. A small team. A clear scoring rubric. A decision date that doesn't move. This post is the whole method: the 10-question rubric, the traps that quietly sink evaluations, and the specific tools (Asana, Monday, ClickUp, Notion, Quire) where each rubric question tends to expose a real difference.

Why Do Long PM Tool Trials Fail?

The obvious failure mode of a six-month trial is that it takes six months. The less obvious ones are worse.

Sunk-cost bias. After two months of evaluation, nobody wants to say the finalist doesn't work, because that would mean admitting two months of wasted effort. So the team finds reasons to make it work. You end up with a tool chosen by inertia, not by fit.

Committee averaging. Large evaluation committees produce average decisions. The loudest stakeholder wins on the features they care about. The quietest ones defer. Nobody gets a tool that works great for their specific function. Everyone gets a tool that's acceptable for everybody.

Problem drift. Your team's pain changes every quarter. A tool that solved last quarter's problem might not solve next quarter's. Long trials make you solve yesterday's problem slowly.

Demo-fit illusion. Every tool looks great in week one. The real problems show up in weeks three through six, and by then the evaluation keeps rolling, which tempts the team to write the problems off as teething issues instead of signal.

The fix is constraint. Give the evaluation two weeks, one real project, and a small team. The constraints force honesty.

How Do You Run a Two-Week Evaluation Sprint?

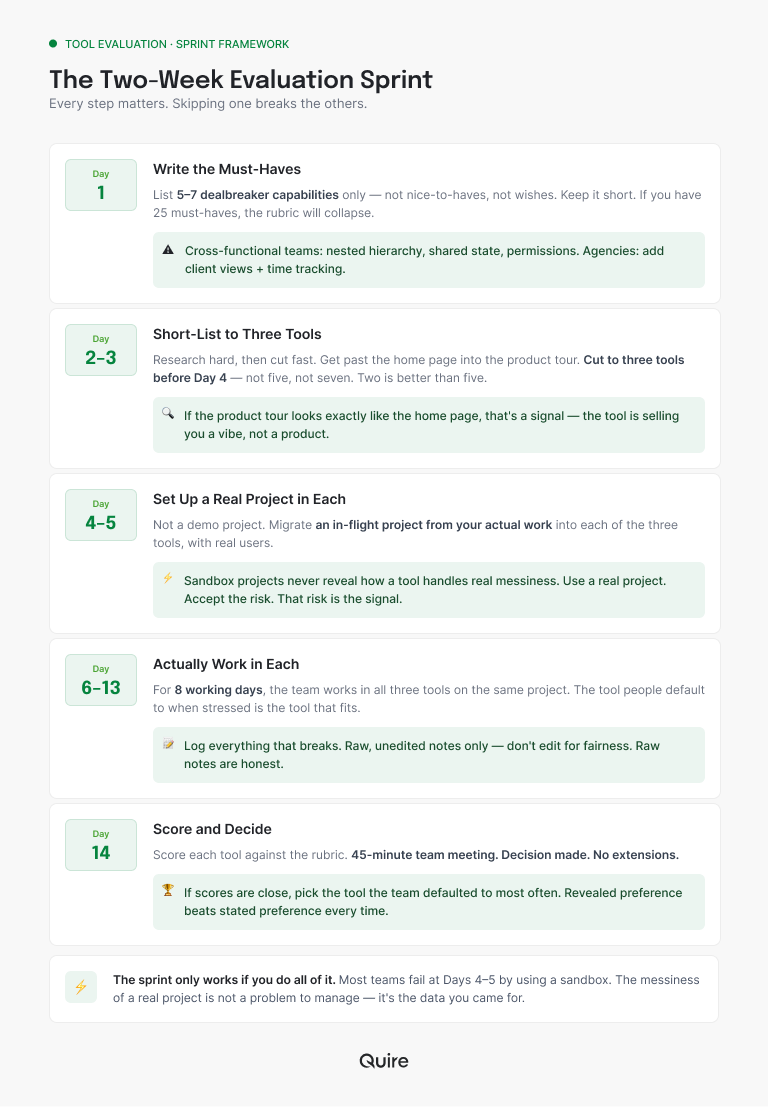

two-week PM evaluation sprint timeline

Here's the structure. Every step matters, and skipping one breaks the others.

Day 1: Write the Must-Haves

Before any demo, write down the five to seven capabilities your next tool must have. Not nice-to-haves. Not wishes. Actual dealbreakers. Keep the list short. If you have 25 must-haves, you'll find something to love in every tool and something to hate in every tool, and the rubric collapses into noise.

For cross-functional teams, the short list usually includes nested task hierarchy, shared cross-team state, and a permission model that doesn't fight you. For agencies, add client-facing views and time tracking. For growing teams specifically, the list depends on where you sit on the Scale Curve.

Days 2–3: Short-List to Three Tools

Research hard, then cut fast. Vendor home pages are written by marketing (we would know). Get past the home page and into the product tour. If the tour looks exactly like the home page, that's a signal: the tool is selling you a vibe, not a workflow.

Cut to three tools before Day 4. Not five. Not seven. Three. Two is better than five.

Days 4–5: Set Up a Real Project in Each

Not a demo project. Not "let me just add a few tasks." An in-flight project from your actual work, migrated into each of the three tools, with a small team of real users.

This is where most evaluations quietly fail. Teams use a sandbox project to be safe, and then never learn how the tool handles a real project with real messiness, real stakeholders, and real deadline pressure. Use a real project. Accept the risk. That risk is the signal you came for.

Days 6–13: Actually Work in Each

For eight working days, the team runs all three tools at once on the same project. Yes, it's redundant. Yes, it's a little annoying. That's the point. The tool people default to when they're stressed and behind is the tool that actually fits.

Log everything that breaks. Every "the update didn't reach me," every "I can't find X," every "this is taking too long." Write it down in the moment. Don't edit for fairness later. Raw notes are honest notes.

Day 14: Score and Decide

The rubric goes here (next section). Score each tool. The small team meets for 45 minutes. Decision made. No extensions, no "let's give it one more week."

If the scores are close, pick the one the team reached for most often during the eight working days. That's revealed preference, and it beats stated preference every time.

What's the Best 10-Question Scoring Rubric?

Score each tool 1 to 5 on each question. Higher is better. Total out of 50.

# Question Why it matters
1 Did work actually happen in this tool, or did people work around it? The single best predictor of long-term fit.
2 Could a new team member onboard in under an hour? Onboarding time compounds across every new hire forever.
3 Did reporting come from task state, or did someone rebuild it? Tools where reporting is separate create the status meeting problem.
4 Did cross-team dependencies hold together without reconciliation? Where cross-functional tools usually break quietly.
5 Does mobile work well enough to trust? Asynchronous work lives partly on phones now.
6 Does the permission model scale without duplicating data? Hidden complexity killer.
7 Can stakeholders view without a paid seat? Otherwise you'll maintain a parallel reporting system.
8 Does nested hierarchy support the depth we actually need? Flattening complex projects is a decade-long tax.
9 Is pricing predictable as the team grows? Some tools have cliff-pricing that hits around 25 seats.
10 Is the team still using it voluntarily on day 14? Revealed preference is more honest than stated preference.

Add the scores. The winner is the one with the highest total, not the one with the flashiest demo. If two tools land within 5 points of each other, use Question 10 as the tiebreaker.

Where Does the Rubric Separate Tools Most?

The questions that expose real differences are rarely the flashy ones. Question 2 (onboarding under an hour) tends to go against the heavier all-in-one tools, where ClickUp's sheer surface area is the cost of its power. Question 3 (reporting from task state) is where docs-first tools like Notion ask someone to rebuild a status view by hand. Question 7 (stakeholders viewing without a paid seat) punishes strict per-seat models like Monday's the moment you have 30 clients or execs who just want to look. Question 8 (nested hierarchy you actually need) separates real task trees from glorified checklists, which is where Asana and Quire tend to pull ahead of flatter tools. The rubric isn't rigged toward any one product. It just asks the questions a demo is designed to skip.

When Should Stakeholders Be Involved?

Stakeholders should be involved, just not continuously. The shape that works:

Day 1: the executive sponsor approves the eval timeline and the must-have list. Five minutes. Don't negotiate this in a meeting. Send it in writing.

Day 14: the evaluation team presents the score and the recommendation. The sponsor signs off or pushes back with a reason.

Between: the sponsor is informed, not consulted. If they want to weigh in daily, the eval quietly turns back into a six-month project.

The same logic applies to the broader team. Keep the evaluation team small (3 to 5 people), and bring in async feedback from everyone else only once the finalists are down to two.

What Are the Red Flags During a PM Tool Evaluation?

Watch for these. They predict post-purchase regret better than any feature list does.

"We'll configure it for you." If the sales rep offers a customer success specialist to get you set up, the tool is more complex than the demo suggests. Self-serve setup should be possible. Ask how many of their customers are still self-sufficient six months after "done by CS."

"It's on the roadmap." Treat this as "no." Roadmaps slip. Buy what exists today, not what's promised for Q3.

"You can do that with a Zapier integration." Any capability that needs a third-party integration isn't really a capability. It's a dependency that will break, change its pricing, or add latency at the worst possible moment.

Onboarding takes more than an hour for a new user. If walking a teammate through "how we use this tool" takes a full meeting, the structure is too idiosyncratic. It only gets worse as more people need to learn it.

Pricing that jumps at a specific seat count. Some tools price gently from 5 to 24 seats and then triple at 25. Ask the rep to show you the full pricing curve. If they hedge, assume the worst.

How Do You Document the Final Decision?

Once you've scored and decided, write the decision down in a one-page doc. Five sections:

  1. What we picked and why (3 to 5 sentences).
  2. What we almost picked, and why not (so future you can re-evaluate without redoing the work).
  3. Must-haves the tool covered versus gaps we're knowingly accepting.
  4. Migration plan (rough; see the outgrowing your tool post for the detailed version).
  5. When we'll re-evaluate (usually annual, or at the next Scale Curve transition).

This doc matters because the decision will get questioned in six months. "We just picked it" doesn't hold up. "We ran a two-week eval against these criteria, here's the rubric, here's what we accepted" does.

What Does the Sprint Look Like in Practice With Quire?

We'll be specific, so you can compare against the tool you're actually evaluating. A two-week sprint in Quire usually plays out like this.

Day 1: import an existing project (CSV from your old tool, or rebuild it natively in about 30 minutes). Set up nested tasks three or four levels deep. Add a few team members.

Days 2 to 13: run the project for real. Standups happen on the project page. Stakeholder updates live as a recurring task. Cross-team handoffs use task assignment plus a comment thread. The team works on mobile, on desktop, and through the Claude MCP integration if AI workflows are in scope.

Day 14: score against the rubric. The strongest signal you'll get is whether the team is still using Quire voluntarily on Day 14. If they've drifted back to the old tool, the rubric score doesn't matter. That drift is the answer.

This mirror-image method works for any tool. The point is to run real work in the candidate, not to admire it in a demo.

If you want to run the sprint with us, the Quire free tier gives you full feature access for 30 days, long enough to run two sprints if the first one is close.

How Does Tool Choice Change at Scale?

This process works for any growing team, but the stakes rise at different points on the Scale Curve. Stage 2 teams (10 to 25 people) can afford to be a little wrong, because migration is still cheap. Stage 3 teams (25 to 75) can't, because a migration at that size takes a month and costs real throughput. Match the rigor of the evaluation to the cost of getting it wrong.

When Is Quire Not the Right Fit?

A method post that only ever points at its own product isn't worth much, so here's where Quire loses the rubric honestly.

  • You need a heavy, automation-first workflow engine. If your evaluation is really about branching automations, custom fields on everything, and a rules engine that reroutes work, ClickUp or a dedicated workflow tool will likely out-score Quire on your must-have list. Score it and move on.
  • You're a solo user with a simple list. The two-week sprint assumes coordination cost across a team. If it's just you and a to-do list, Quire works, but a lighter app will win on Question 2 and you won't miss the hierarchy.
  • You need an engineering-native tracker tied to pull requests and sprints. Teams living entirely in Jira-style dev workflows should keep that muscle memory. Quire fits cross-functional and ops-shaped work better than pure-engineering ticket flow.

If two of those three describe your team, you already have your answer, and you just saved yourself two weeks. (We're oddly okay with that.)
